MEC&F Expert Engineers : AMERICAN MADE CRAP: Cracked steel girder beam inside the Salesforce Transit Center forces the shutdown of the newly-opened $2 billion station in San Fransisco, California

Monday, October 1, 2018

AMERICAN MADE CRAP: Cracked steel girder beam inside the Salesforce Transit Center forces the shutdown of the newly-opened $2 billion station in San Fransisco, California









Wednesday, September 26, 201


SAN FRANCISCO, CA (KGO) --


After a second crack was found in another steel supporting beam at San Francisco's Salesforce Transit Center, officials are investigating what caused the problem.

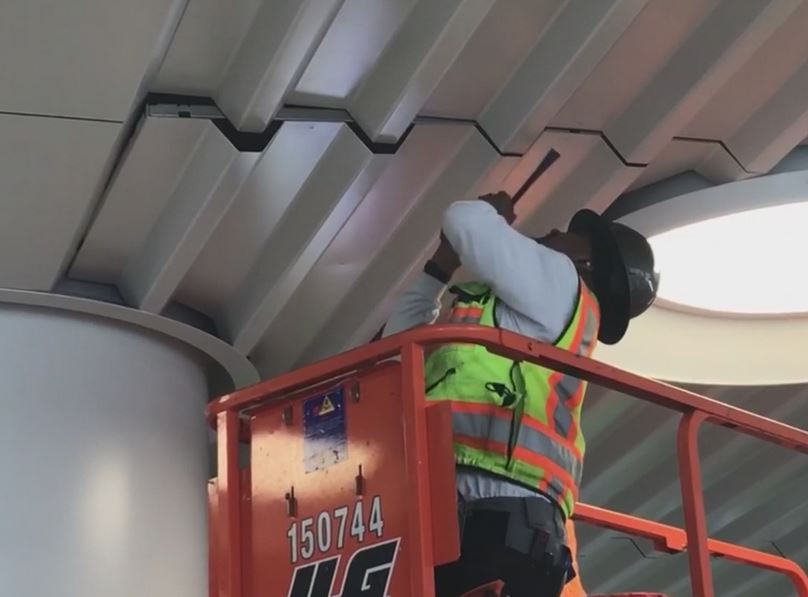

On Wednesday night, workers were busy de-energizing bus lines on Fremont and Howard Streets so that workers can begin safely inspecting and eventually fixing the cracked beam inside the Salesforce Transit Center.

A few blocks away, at the old temporary Transbay Terminal, bus riders were waiting at a crowded bus stop, which is busy once again now that the Transit Terminal is closed for at least the next week.

But not everyone got the message about the closure. There was plenty of confusion at the Salesforce Transit Center, as people were met with police tape instead of their bus home. "It's not even on the app, it's not updated to let me know," explained Kieran Barkley, whose Google Maps and AC Transit apps still directed him to the Salesforce Transit Center.

"Now I'm kind like oh, I have to find a new way to get home. It's kind of inconvenient!"

The questions are not only from commuters. Executive Director of Transbay Joint Powers Authority, Mark Zabaneh, revealed photos on Wednesday of the 2.5-foot-long crack discovered in the load-bearing steel beam Tuesday morning.

A second smaller crack was discovered in an adjacent beam. Zabaneh says the possible cause of the defects are numerous at this point -- "three possibilities, fabrication, installation and design."

The senior construction manager, Dennis Turchon, says all the steel in the Transit Center is American made.

Officials revealed Wednesday that a second steel beam was found to have cracks on the third level of the Salesforce Transit Center in downtown San Francisco.


The beams in question were made by Herrick Steel, which is headquartered in Stockton, but also has an office in San Ramon.

"We have seven different fabricators that have provided all the steel on this project. Herrick is only one of them, but they're probably about 30 percent of the whole steel that was put onto the project," said Turchon.

When ABC7 called Herrick Steel, it had no comment, but their website shows that they have contributed steel to dozens of buildings in San Francisco that make up the city's modern skyline, including the Salesforce Tower.

UC Berkeley engineering professor Robert Ritchie says the best case scenario is that the beams are failing due to poor handling or perhaps welding, which he explains is still not an easy fix for the 1.2 million square foot building.

"They would have to look at every weld and structure to see if there are cracks there," Ritchie said.


====================================



Engineers search for cause in cracked beam at transit hub


By JANIE HAR and PAUL ELIAS Associated Press



September 27, 2018


SAN FRANCISCO



San Francisco officials struggled Wednesday to find the source of unusual cracking in support beams that shut down a just-opened, $2 billion transit center meant to serve as a bold architectural statement from a wealthy, high-tech city.

The Salesforce Transit Center opened to great fanfare last month as an embodiment of San Francisco’s reputation for innovation and sustainability. Its rooftop park would provide green space for people to socialize while commuters could take buses from the multistory building that spans three city blocks.

Now, the transit hub named for a cloud computing giant appears to be the latest example of problems in a city brimming with homelessness and poor infrastructure. The shutdown, which officials say will last until the facility can be declared safe, caused chaos during Tuesday’s evening rush hour.

Enveloped in wavy white sheets of metal veil, the five-level center with a towering sky-lit central entrance hall sits in the South of Market neighborhood, where construction is booming. It’s adjacent to the so-called sinking condominium, Millennium Tower, which has settled about 18 inches (45 centimeters) since it opened over a former landfill in 2009.

Officials and construction experts say the transit center’s two cracked beams are not tied to the condo woes, though some homeowners have sued the developer and city alleging construction of the transit facility caused the Millennium Tower to sink.

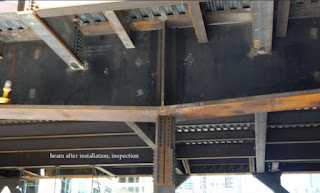

Workers installing roof tiles Tuesday morning found the first crack, about 2½ feet long and 4 inches deep, on a steel beam holding up the transit center’s rooftop park. A second, smaller crack was found later that day on a parallel beam.

Two other similar beams do not show signs of cracking, said Mark Zabaneh, executive director of Transbay Joint Powers Authority, which operates the transit hub.

He said their first priority is to shore up the beams so the facility can reopen while engineers search for a permanent fix. He said he expects the center to remain closed at least through the end of next week.

“We’re working hard to rectify the situation,” Zabaneh said. “We’re very disappointed with what happened; we will get to the bottom of this.”

He said the steel came from Stockton-based Herrick Corp. The beams looked fine when they were installed in January 2016. The problem could be in the fabrication, installation or design of the beams, Zabeneh said.

Construction experts say it’s exceedingly rare for steel girders that support buildings to crack.

Engineer David Friedman said it’s likely the beams arrived without cracks but that once the weight of the roof garden and other structures were added, “new stresses may have exacerbated the possible fabrication flaws.”

The beams likely passed inspection after installation, engineer Joe Maffei said.

“If that’s the case, it’s likely welding caused the problem,” he said.

Mayor London Breed said in a statement that the building’s role in the broader transportation system was too important “not to act quickly to have definitive answers for the public, and someone needs to be held accountable once the cause is determined.”

Buses have been rerouted to a temporary transit center about two blocks away that was used during the center’s construction. A downtown street that runs under the beam also was ordered closed indefinitely, causing a commuting nightmare.

Julianna Cheng, who lives in the neighborhood, burst out laughing when asked about the cracking.

“I find it disappointing but also kind of amusing because they built this really big, they spent a lot of money,” said Cheng, 32. “I feel like the money should have been used for a lot of other things.”

“I don’t know. Maybe this is a sign,” she said.

Earlier this year, San Francisco’s transit agency disclosed that a contractor had installed about 3 miles (5 kilometers) of the wrong grade of rail for its new $1.6 billion subway spur. Several problem trains and buses marred a City Hall celebration of transit week Monday.

The transit terminal, coined the “Grand Central of the West,” opened after nearly a decade under construction. It is expected to accommodate 100,000 passengers each weekday and up to 45 million people a year.

Numerous towering condo buildings have gone up in the booming South of Market neighborhood and several multistory construction projects are underway. Officials voted in 2012 to scrap building-height restrictions to encourage growth near the transit hub as San Francisco looks to lure technology companies from Silicon Valley.

Salesforce, which opened its adjacent 61-story Salesforce Tower earlier this year, bought naming rights to the transit center in 2017 as part of a 25-year, $110 million sponsorship agreement.
